The Ecowoods Well-Installed Framework

A published specification for judging a hardwood flooring installation — six pillars and 27 binary criteria. Every criterion is sourced to a technical paper on this site. It is written to be used on any contractor in the GTA, including us.

Version 1.0Published 2026-08-1913 critical criteriaFree to cite

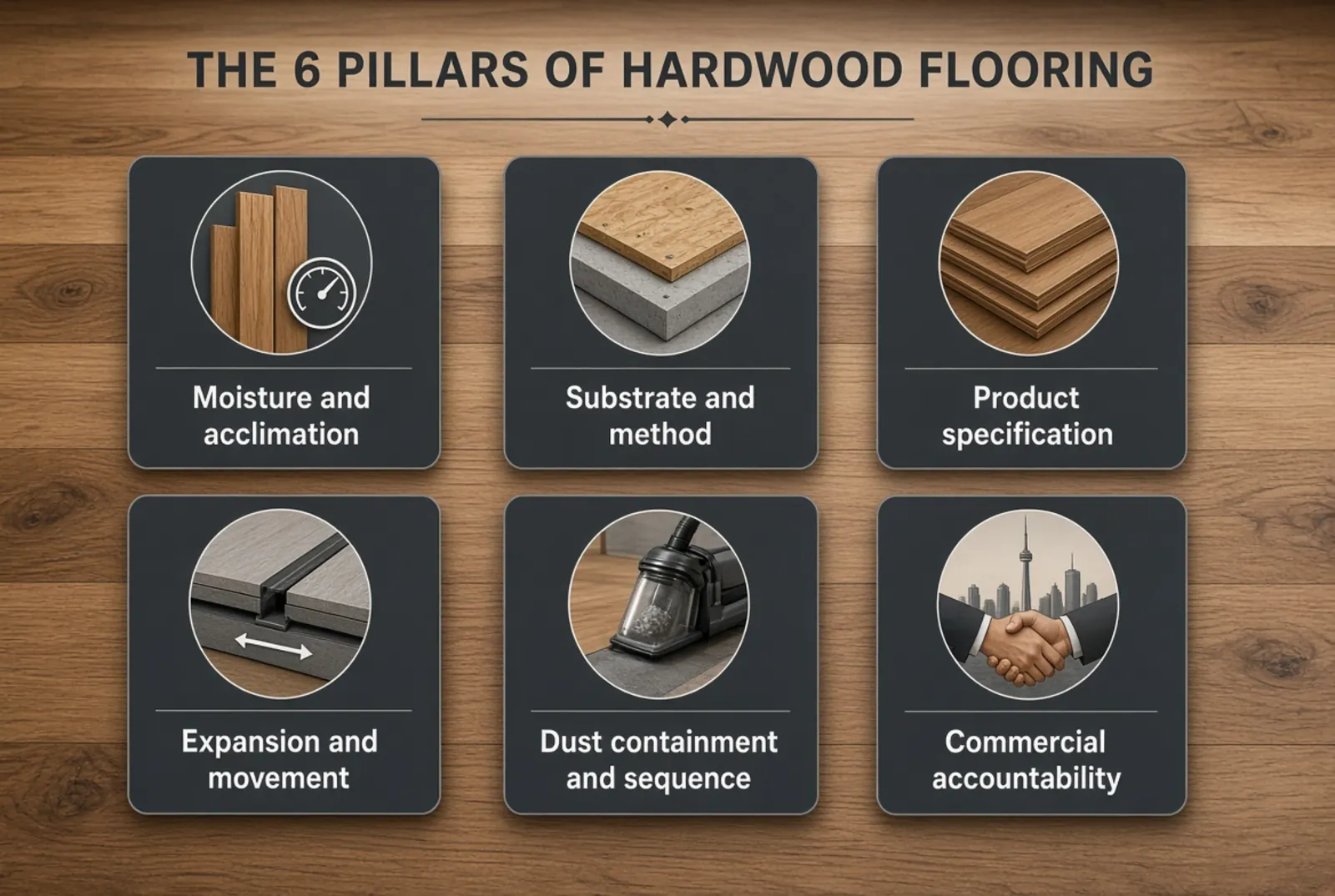

Overview of the six pillars of the Ecowoods Well-Installed Framework, arranged around a cutaway floor assembly with the Toronto skyline behind it.
The six pillars of the Well-Installed Framework. Each one is a question a correctly installed floor can answer, and the pillar names in the panels below are the authoritative wording.View full size Overview of the six pillars of the Ecowoods Well-Installed Framework, arranged around a cutaway floor assembly with the Toronto skyline behind it.

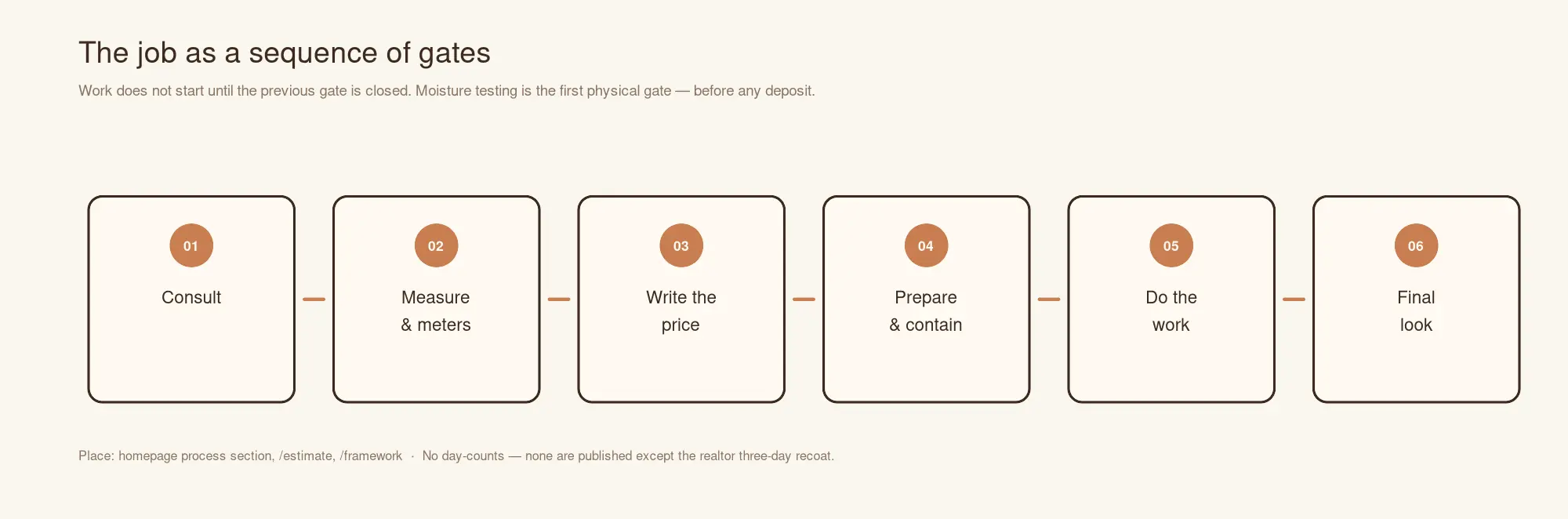

Six gates from first consultation to the final walk-through, with moisture testing closing the first physical gate before any deposit is taken.
Each gate has to close before the next opens. The first physical one is moisture, which is why nothing is scheduled off a phone call.View full size Six gates from first consultation to the final walk-through, with moisture testing closing the first physical gate before any deposit is taken.

How to use it

Three ways this is meant to be used

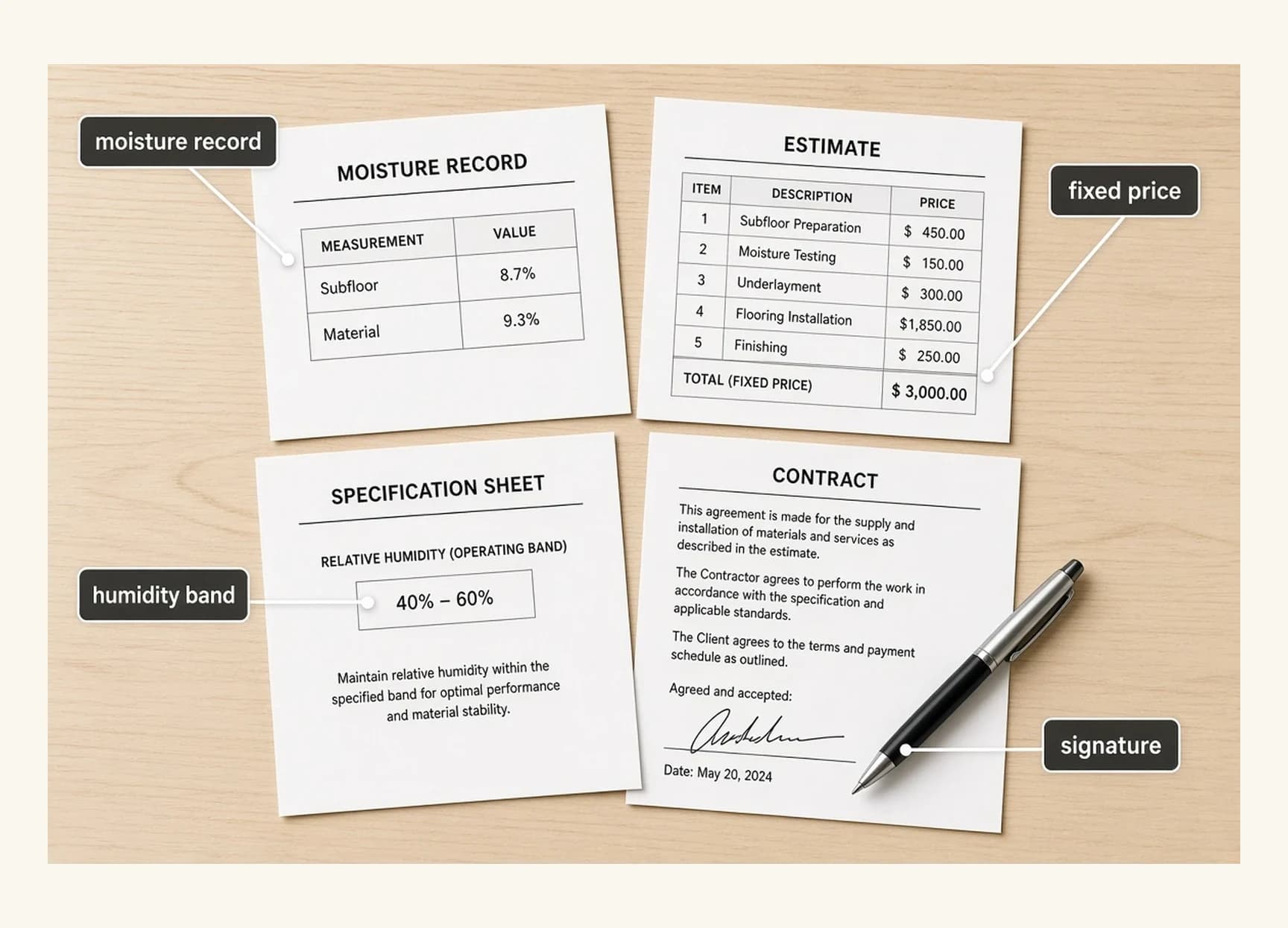

The four documents a homeowner should have before a deposit — a moisture record sheet showing subfloor and material readings, a fixed-price estimate, a stated operating humidity band, and a signed contract.

What to ask for before any deposit: written moisture readings of both the subfloor and the material, a fixed price, the humidity band the floor is specified for, and a signature. Documents shown are illustrative examples, not a client's paperwork.View full size The four documents a homeowner should have before a deposit — a moisture record sheet showing subfloor and material readings, a fixed-price estimate, a stated operating humidity band, and a signed contract.

As a homeowner

Take the criteria to every quote you are holding. Any critical criterion answered “no” is an unresolved defect in that quote, regardless of the price.

As a contractor

Use it as a pre-installation checklist. It is published under CC BY — attribute the version and you may reproduce it.

As a citation

Every criterion has a permanent id. Cite as Well-Installed Framework v1.0, criterion 2.4; ids are never reused or renumbered in place.

Pillar 1

Moisture and acclimation

Wood exchanges moisture with the air continuously and moves as it does. This pillar establishes that the movement was measured and planned for before anything was fastened down.

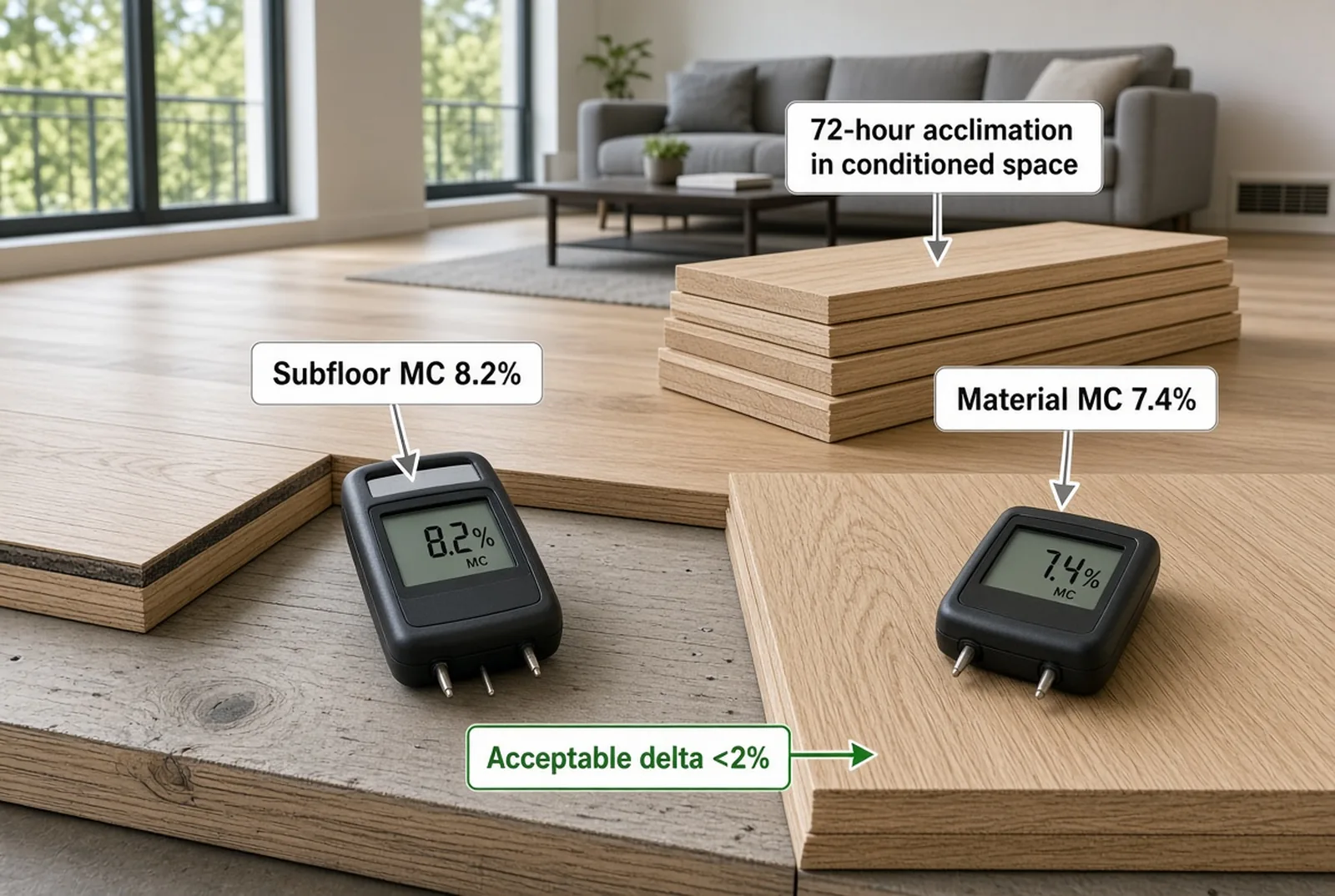

Two digital moisture meters on a floor assembly — one reading 8.2 percent in the subfloor, one reading 7.4 percent in the flooring material — with boards acclimating on the finished floor of the conditioned room behind them.
Pillar 1 — Moisture and acclimation: both sides of the system are measured, and the material spends a minimum of 72 hours in the actual conditioned space. The meter values shown are a worked example; the acceptable difference between them is the manufacturer's and ours, and it is written into the estimate.View full size Two digital moisture meters on a floor assembly — one reading 8.2 percent in the subfloor, one reading 7.4 percent in the flooring material — with boards acclimating on the finished floor of the conditioned room behind them.
  1. 1.1Critical

    Was the subfloor moisture content measured, and were the readings written down?

    If not: A floor installed over a wet subfloor will cup, crown, gap or buckle. No warranty language overrides physics.

    Source: moisture testing

  2. 1.2Critical

    Was the flooring material itself moisture-tested, separately from the subfloor?

    If not: Every board arrives with its own moisture history. Testing only the subfloor measures half the system.

    Source: moisture testing

  3. 1.3Critical

    Do both readings sit inside the manufacturer's stated acceptable difference between material and subfloor?

    If not: A large moisture differential guarantees dimensional change after installation, regardless of how well the floor was laid.

    Source: moisture testing

  4. 1.4Major

    Was testing performed twice — at the estimate, and again immediately before installation begins?

    If not: Conditions change between quoting and installation. A single reading months earlier describes a building that no longer exists.

    Source: moisture testing

  5. 1.5Critical

    Will the material acclimate for a minimum of 72 hours in the actual conditioned space where it will be installed?

    If not: Acclimating in a garage, a hallway or an unheated room conditions the wood to the wrong environment.

    Source: protocol

Pillar 2

Substrate and method

Installation method is determined by what the floor is going onto, not by preference, habit or price. This pillar establishes that the substrate decided the method.

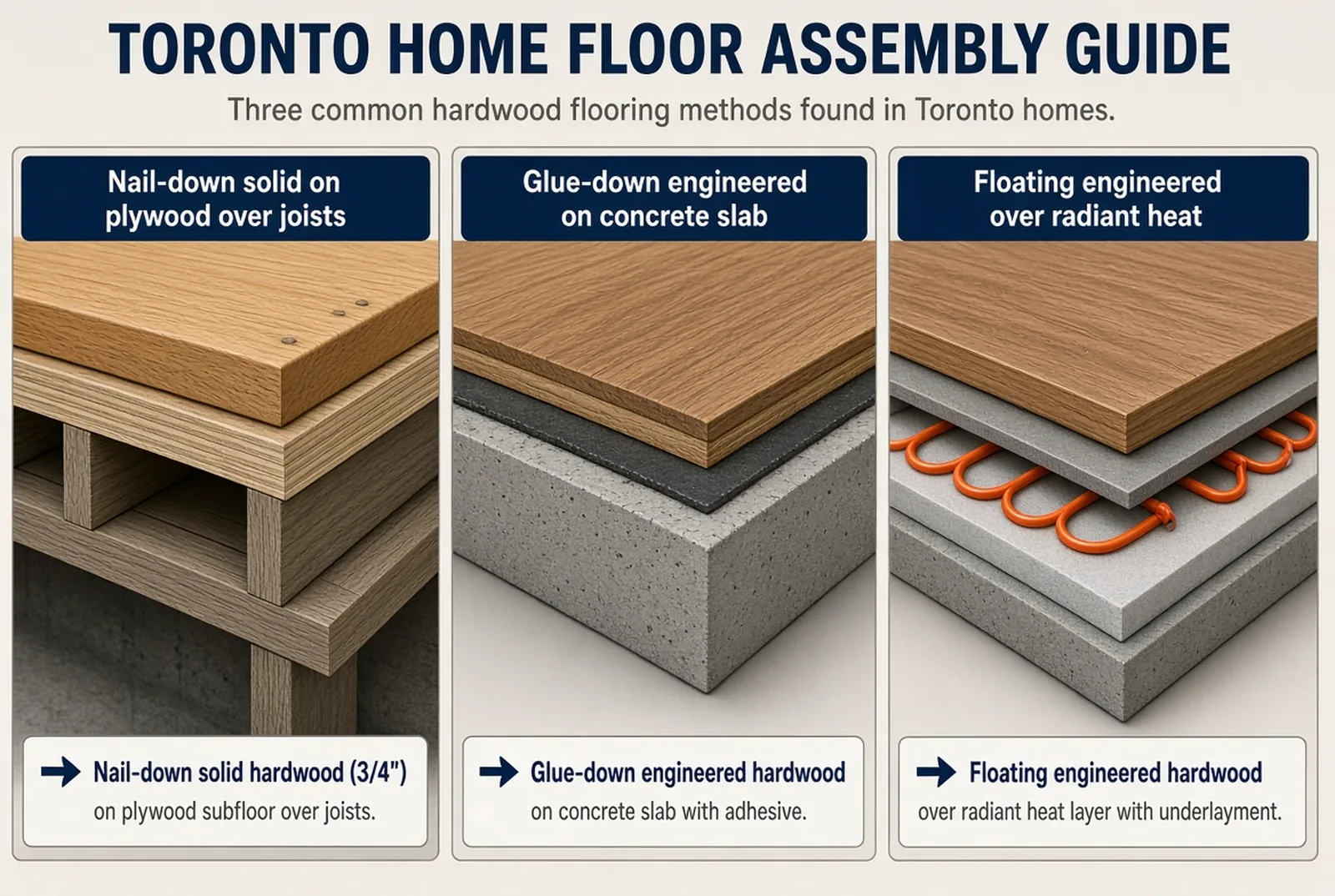

Three floor assemblies cut open side by side — solid boards nailed into plywood over joists, engineered boards glued to a concrete slab, and engineered boards floating over radiant heating tubes.
Pillar 2 — Substrate and method: the thing underneath decides how the floor is fastened. Plywood over joists takes nail-down solid; a slab takes glue-down engineered; radiant heat takes a floating engineered assembly.View full size Three floor assemblies cut open side by side — solid boards nailed into plywood over joists, engineered boards glued to a concrete slab, and engineered boards floating over radiant heating tubes.
  1. 2.1Critical

    Was the substrate identified explicitly — plywood over joists, concrete slab, or radiant?

    If not: Every downstream decision depends on this answer. A method chosen before the substrate is known is a guess.

    Source: method and substrate

  2. 2.2Critical

    Does the proposed method match the substrate — nail-down on plywood, glue-down on concrete, floating over radiant or where acoustic separation is required?

    If not: Method mismatched to substrate is the failure that cannot be corrected later without lifting the floor.

    Source: method and substrate

  3. 2.3Major

    Was the substrate assessed for flatness and condition before the price was fixed?

    If not: Substrate correction discovered mid-job is the single most common source of change orders on a hardwood project.

    Source: fixed price

  4. 2.4Critical

    If the substrate is concrete, a condominium slab, or radiant heat, was engineered construction specified rather than solid?

    If not: Solid hardwood over concrete or radiant has no cross-ply core to resist seasonal movement. The construction is what provides the stability.

    Source: decision tree

Pillar 3

Product specification

The correct product is the one that will still look and perform correctly in twenty years. This pillar establishes that the house specified the floor, not the budget.

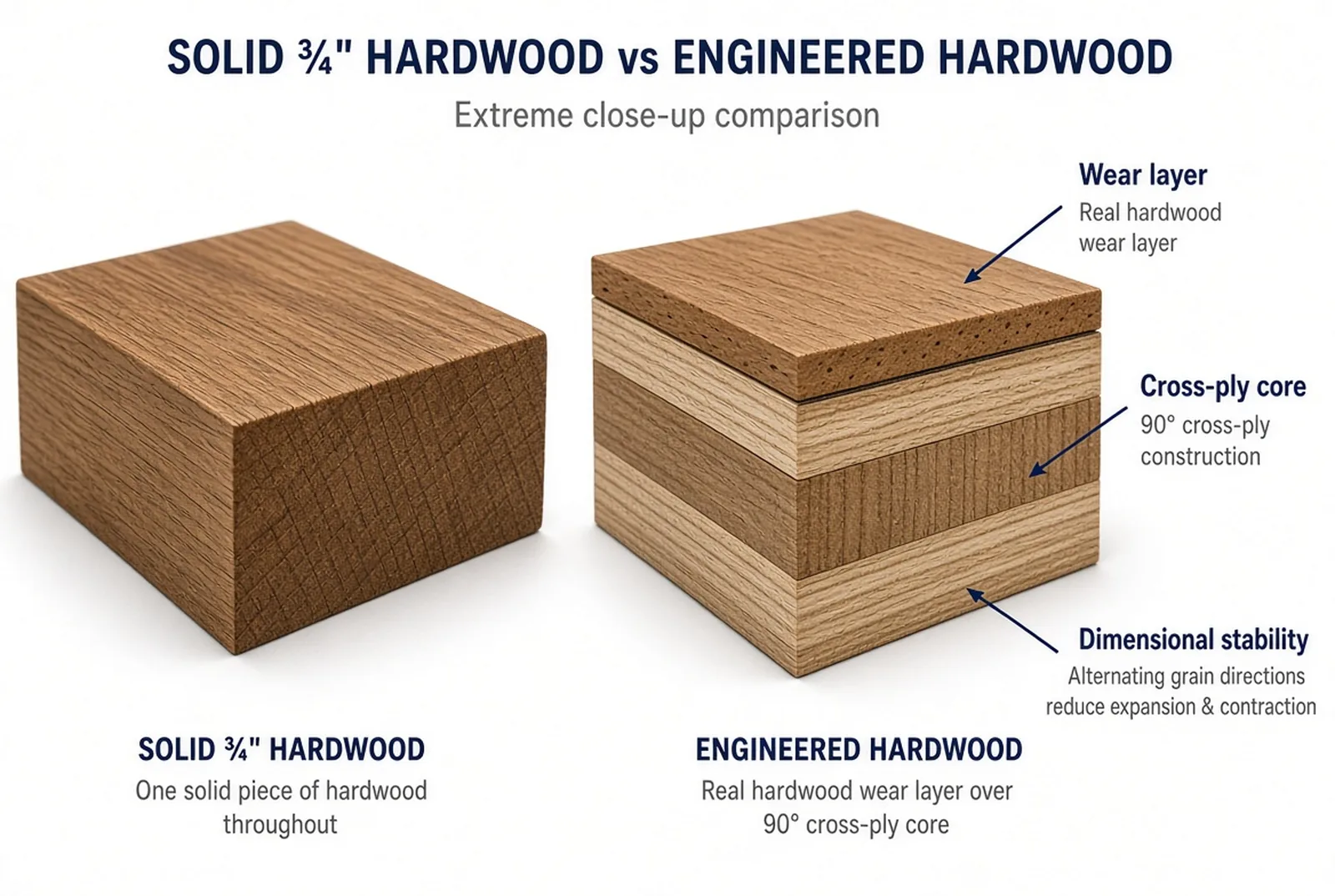

Extreme close-up of a solid three-quarter-inch oak board beside an engineered board cut open to show a hardwood wear layer over a cross-laminated core.
Pillar 3 — Product specification: construction decides performance, not appearance. A solid board is one piece of wood through its whole thickness; an engineered board is a real hardwood wear layer over plies laid at ninety degrees to each other.View full size Extreme close-up of a solid three-quarter-inch oak board beside an engineered board cut open to show a hardwood wear layer over a cross-laminated core.
  1. 3.1Critical

    Was the solid-versus-engineered decision explained in terms of the substrate and the climate load, rather than price or preference?

    If not: A product sold on margin instead of specified on physics is a failure with a delay built in.

    Source: decision tree

  2. 3.2Major

    Was species hardness discussed against the actual traffic and household this floor will carry?

    If not: Species selection made on appearance alone produces a floor that looks correct on handover and wears wrong within a few years.

    Source: species

  3. 3.3Major

    If the home sees large seasonal humidity swings, was that raised as a reason to prefer engineered construction?

    If not: Toronto indoor RH runs from below 25% in winter to above 60% in summer. A product specified without reference to that range was specified for a different city.

    Source: climate reality

  4. 3.4Advisory

    Was the finish system named specifically, rather than described only as "polyurethane"?

    If not: Finish system determines cure time, recoat interval and how the floor is maintained for its whole life. An unnamed system cannot be maintained correctly.

    Source: sequence

Pillar 4

Expansion and movement

The question is never whether a floor will move. This pillar establishes that room for the movement was designed in rather than discovered later.

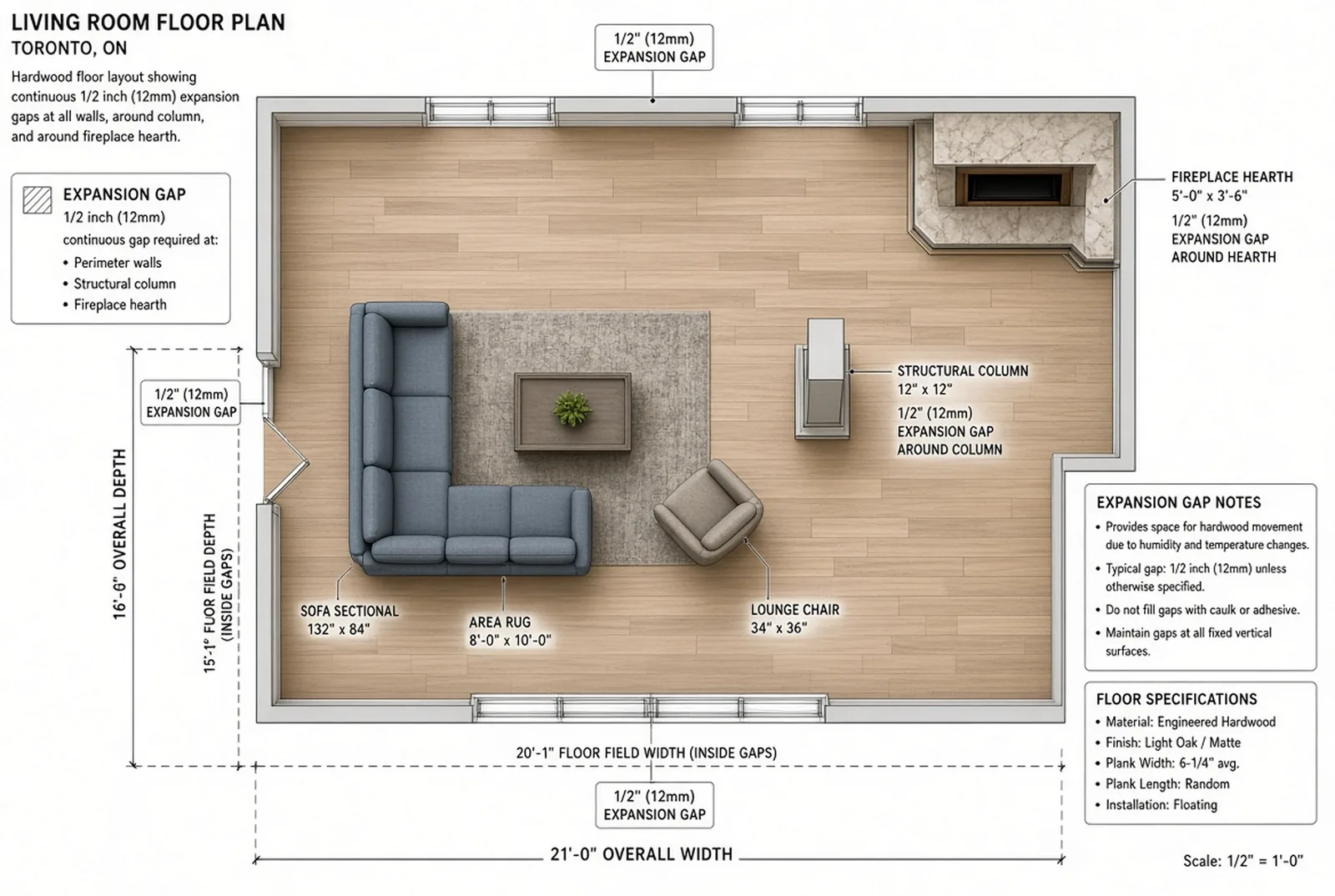

Plan view of a Toronto living room floor with a continuous half-inch expansion gap at every wall and running unbroken around a structural column and a fireplace hearth.
Pillar 4 — Expansion and movement: the gap goes at every wall and every fixed object in the room, not only around the perimeter. Half an inch, roughly 12 mm, hidden under the baseboard and never filled.View full size Plan view of a Toronto living room floor with a continuous half-inch expansion gap at every wall and running unbroken around a structural column and a fireplace hearth.
  1. 4.1Critical

    Are expansion gaps specified at every wall and every fixed object — not only at the perimeter?

    If not: A floor with nowhere to expand will buckle or tent. Fixed objects mid-field are where this is most often missed.

    Source: protocol

  2. 4.2Major

    Was the safe indoor humidity band the floor needs to live in — and who is responsible for maintaining it — stated in writing?

    If not: A floor handed over without a stated operating range has no defensible warranty boundary, in either direction.

    Source: climate reality

  3. 4.3Advisory

    Were the specific failure modes — cupping, crowning, seasonal gapping, buckling, edge peaking — named and explained rather than dismissed?

    If not: A contractor who will not name the failure modes either does not know them or does not intend to be accountable for them.

    Source: failure modes

Pillar 5

Dust containment and sequence

Sanding and finishing is a sequence of machines, each of which does something the others cannot. This pillar establishes that the sequence was complete and the dust was contained.

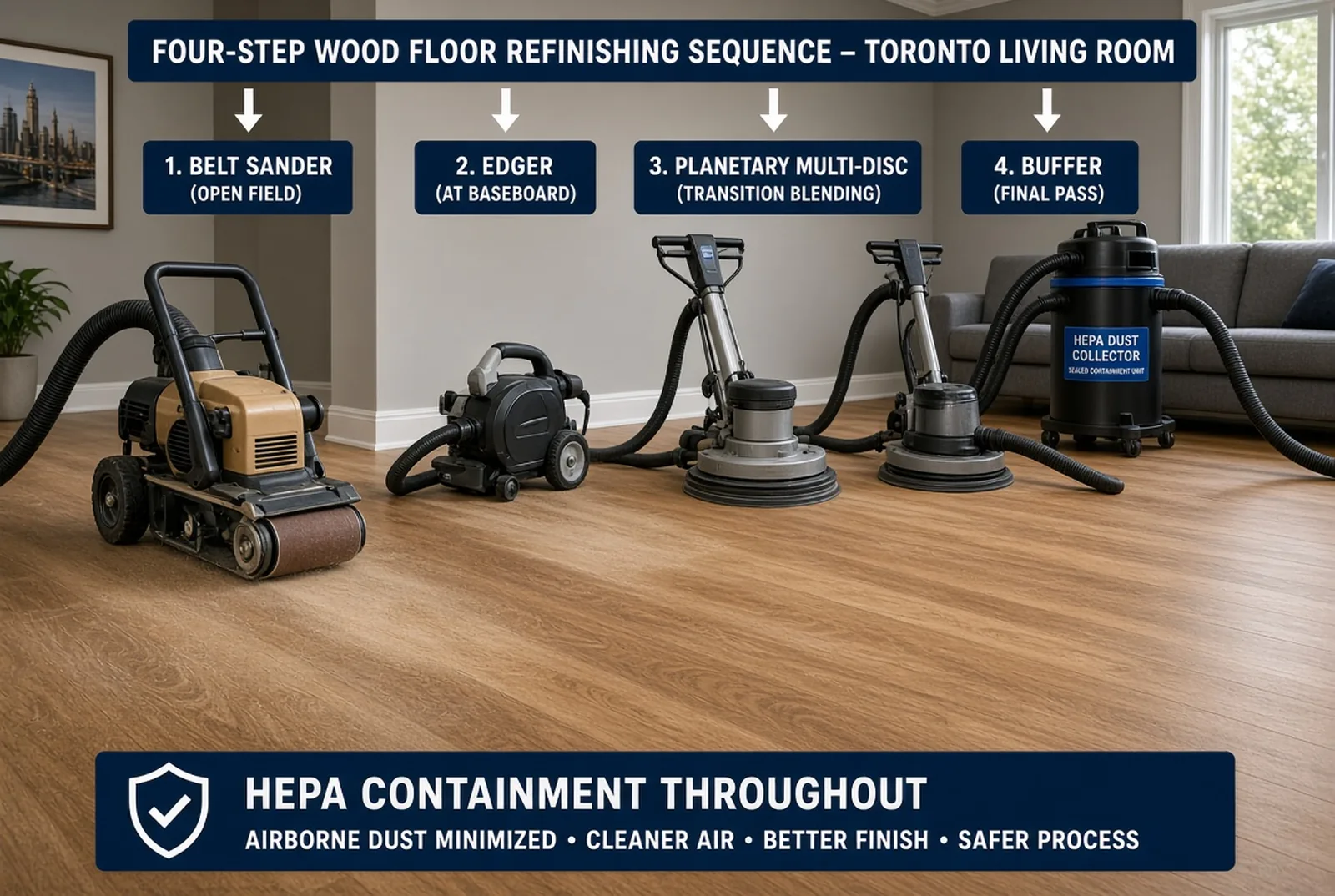

Four sanding machines shown in working sequence in one room — belt sander in the open field, edger tight to the baseboard, planetary sander blending the two, buffer on the final pass — each with a hose running to a sealed HEPA collector.
Pillar 5 — Dust containment and sequence: four machines, in that order, every one of them hosed to a sealed collector. Skipping the planetary sander is what leaves the halo where the edger stopped.View full size Four sanding machines shown in working sequence in one room — belt sander in the open field, edger tight to the baseboard, planetary sander blending the two, buffer on the final pass — each with a hose running to a sealed HEPA collector.
  1. 5.1Critical

    Is HEPA dust containment used throughout the process, not only at final cleanup?

    If not: Dust generated during sanding is respirable and travels through the whole building. Cleanup afterwards addresses what settled, not what was breathed.

    Source: protocol

  2. 5.2Major

    Does the plan include an edger on every perimeter and detail, with grits matching the field?

    If not: A big machine cannot reach a perimeter. Skipping or under-gritting the edger leaves a visible halo around every room that only shows once the finish goes on.

    Source: edger

  3. 5.3Major

    Is a planetary or multi-disc pass included to blend the field into the edges?

    If not: Without a blending pass, the boundary between what the belt sander reached and what the edger reached stays visible for the life of the floor.

    Source: planetary

  4. 5.4Major

    Is intercoat screening between finish coats part of the quoted scope?

    If not: Skipping intercoat screening is invisible on handover day and produces an uneven surface and weaker coat adhesion.

    Source: sequence

  5. 5.5Major

    Was a cure period stated — distinct from "dry to walk on" — with what may and may not go back on the floor during it?

    If not: Furniture and rugs returned to an uncured finish mark it permanently. Dry and cured are different dates.

    Source: sequence

Pillar 6

Commercial accountability

Every pillar above is only as good as the contract behind it. This pillar establishes that someone is accountable in writing when the floor is five years old.

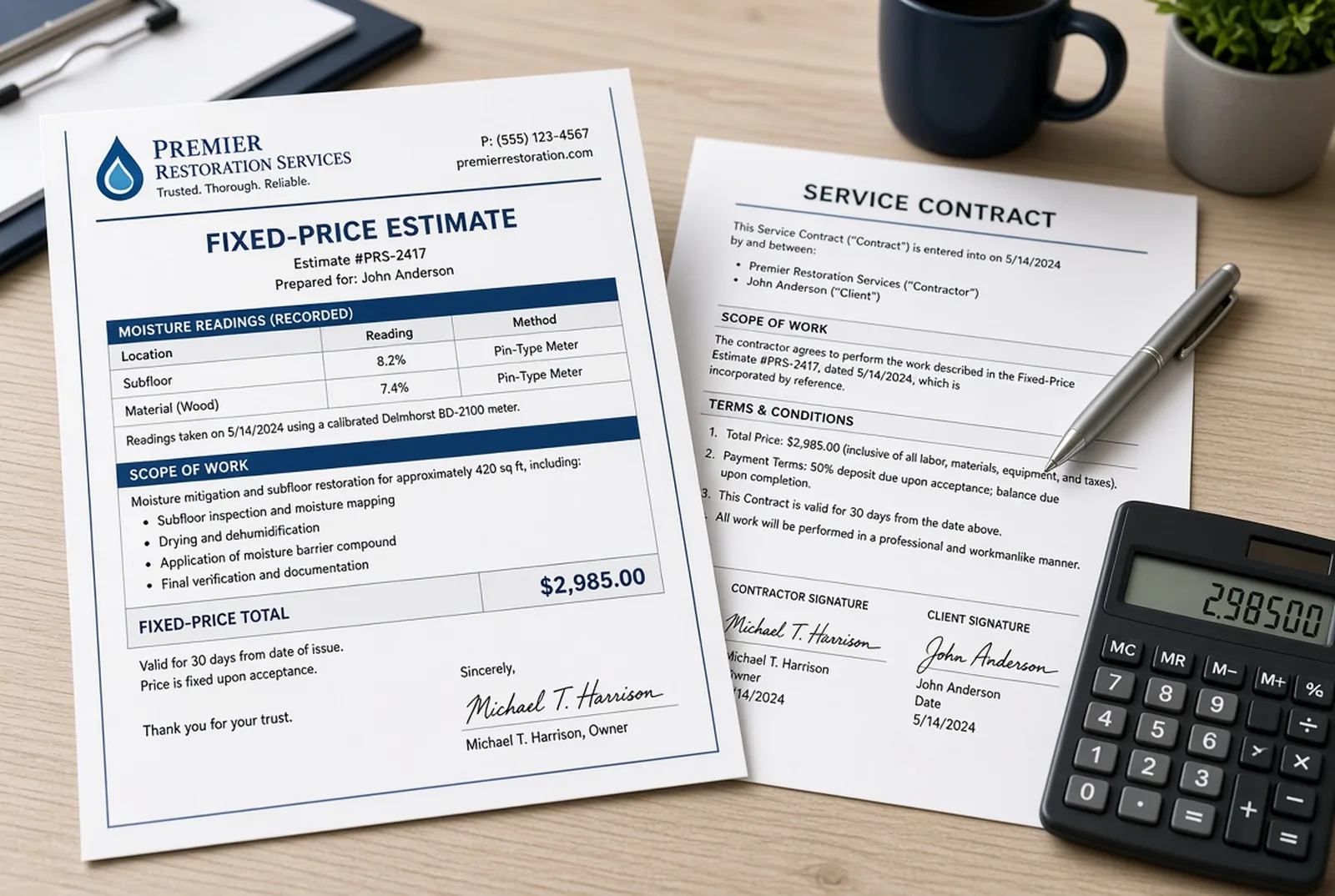

A printed fixed-price estimate on a desk showing the recorded subfloor and material moisture readings, the scope and the total, beside a signed contract.
Pillar 6 — Commercial accountability: the readings and the price exist in writing, signed, before any deposit changes hands. The document shown is an illustrative example, not a client's estimate.View full size A printed fixed-price estimate on a desk showing the recorded subfloor and material moisture readings, the scope and the total, beside a signed contract.
  1. 6.1Critical

    Is the price fixed in writing, with no open-ended "unforeseen conditions" change-order language?

    If not: An open-ended price transfers the cost of the contractor's missing due diligence onto the homeowner, after the deposit.

    Source: fixed price

  2. 6.2Major

    Will the work be performed by salaried employees rather than day-labour subcontractors?

    If not: A crew that will not be there next season has no stake in how the floor performs next season.

    Source: installer checklist

  3. 6.3Critical

    Is there true lifetime workmanship warranty language in the contract itself?

    If not: A warranty described in conversation and absent from the contract is not a warranty.

    Source: installer checklist

  4. 6.4Critical

    Would they refuse the job if the substrate or the conditions were wrong — and have they said so plainly?

    If not: A contractor who will install over any condition is quoting on volume. The willingness to walk away is the only real evidence of a standard.

    Source: what to demand

  5. 6.5Major

    Were the written moisture readings provided before any deposit was requested?

    If not: Testing after the deposit inverts the incentive: the finding can no longer change the decision.

    Source: what to demand

  6. 6.6Advisory

    Are manufacturer warranties passed through in writing, naming the manufacturer and the product?

    If not: A manufacturer warranty that is never registered or documented cannot be claimed against years later.

    Source: installer checklist

Applied

Guides that apply the framework

The framework says what to check. These say what to do about the answer.

Decision guide

Solid or engineered hardwood

Should I install solid or engineered hardwood in my Toronto home?

5 min
Decision guide

Nail-down, glue-down or floating

Which hardwood installation method is correct for my subfloor?

4 min
Decision guide

How to evaluate a hardwood quote

How do I tell a good hardwood flooring quote from a bad one?

4 min
Reference installation

Condominium over concrete slab

What does a correct hardwood installation over a Toronto condo slab look like, end to end?

5 min
Reference installation

Radiant heat main floor

What does a correct hardwood installation over radiant heat look like, end to end?

5 min
Reference installation

Refinishing an existing hardwood floor

What is the correct machine sequence for refinishing a hardwood floor?

6 min
Decision guide

Hardwood flooring cost in Toronto

How much does hardwood flooring cost in Toronto and the GTA?

6 min
Decision guide

How to choose a hardwood contractor in Toronto

How do I choose a hardwood flooring contractor in Toronto?

5 min
Decision guide

White oak flooring in Toronto

Is white oak the right hardwood for a Toronto home?

5 min
Reference installation

Dustless hardwood refinishing in Toronto

What does dustless hardwood refinishing actually mean in an occupied Toronto home?

4 min
Decision guide

Herringbone, chevron and parquet in Toronto

Should I install herringbone, chevron or parquet in my Toronto home or condo?

5 min
Reference installation

Red oak

Is red oak the right hardwood floor for a Toronto home?

6 min
Reference installation

Hard maple

Is hard maple the right hardwood floor for a Toronto home?

6 min
Reference installation

White ash

Should I choose white ash flooring in Toronto, given the emerald ash borer?

6 min
Reference installation

Hickory

Is hickory flooring worth it in a Toronto home?

5 min
Reference installation

Black walnut

Is black walnut flooring a good idea in a Toronto home?

5 min

The standard, applied

Four jobs judged against these criteria

Use the criteria above on any contractor in the GTA. These are ours, published with the readings so the criteria can actually be applied to them rather than taken on trust.

Every case study publishes what was measured, not only what was achieved — all of them are here, and each one names the substrate, the species, the readings and the protocol it followed.

Or hand it to us

What we would actually do

Hardwood Flooring Installation · Hardwood Floor Refinishing · Dust-Free Floor Sanding · Hardwood Floor Restoration · Custom Inlays & Borders · Stair Refinishing

Price bands are published before you call: hardwood flooring in Toronto, refinishing, stairs. Applying the criteria above to our own quote is not only allowed, it is the point.

Field catalogue

Take the catalogue with you

The same facts as this page, in a document you can print or forward. Not a quote, and nothing on it asks for your email.

Every field catalogue — the company, the services, the stair case, the framework and the decisions, indexed by series.

Contract

What the version number promises

Criterion ids are permanent. Adding, removing or rewording a criterion is a minor version bump. Changing what a pillar means is a major one. A criterion is never edited in place without the version moving, so a citation to v1.0 will always resolve to the text that was published on 2026-08-19.

No criterion in this framework asserts anything that is not already published in a paper on this site. That constraint is enforced by a build guard, not by editorial intent — scripts/verify-framework.mjs resolves every citation and fails the build on any that does not exist.
